Case study · Banking

Template-Driven Project Management System

A scalable solution built in Brussels to automate, coordinate, and monitor 60,000+ operational projects, from branch mergers to infrastructure upgrades.

.NET DevelopmentSystem ArchitectureWorkflow Automation
Project Engine
Client BNP Paribas Fortis
Headquarters Montagne du Parc 3, 1000 Brussels
Industry Banking
Department Infrastructure
Time spent 4 years
Period 2007–2011
Overview

A reusable, template-based project management platform designed to handle thousands of parallel operational projects with precision and minimal overhead.

Built in Brussels between 2007 and 2011, this system was initially created to manage branch mergers for a large financial institution. It allowed users to define project templates with stakeholder roles, relative task timing, and a central pivot date, such as a merger event, to automatically calculate deadlines. Once instantiated, tasks were assigned to real users, with automated notifications and dashboards ensuring timely execution and oversight. Over time, the system was generalized to support additional use cases, including IT deployments, branch openings, and infrastructure changes.

The Challenge

The organization needed a way to manage hundreds of ongoing operational projects with consistency and accuracy. Manual tracking via spreadsheets was error-prone and unscalable. Each project type, starting with branch mergers, required coordination among multiple departments and strict timing relative to key milestones.

  • Automated task scheduling based on pivot dates
  • Dynamic stakeholder assignment by role
  • Real-time dashboards and overdue alerts
  • Generalized system architecture for any project type

The Result

The final system managed over 60,000 projects, including nearly 500 branch mergers. It scaled seamlessly across teams and initiatives, providing structure and accountability without burdening users. Built using ASP.NET and SQL Server, the platform remains in use today, a testament to its flexibility and robust design.

  • 60,000+ projects coordinated
  • 500+ mergers successfully managed
  • Adapted for various use cases beyond original scope
  • Still operational after 15+ years
2026 update  Project Engine's method is now offered as FlowPilot: a planning methodology we apply to a client's repeated projects and set up on tools they own. →See FlowPilot
Gallery

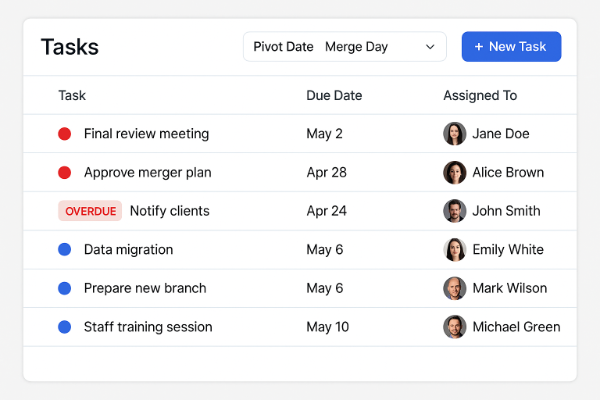

Task dashboard showing project tasks with due dates, assigned users, and overdue indicators.
Task dashboard

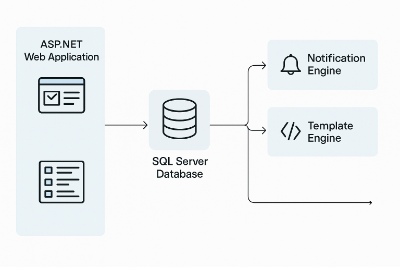

Simplified system architecture diagram of an ASP.NET application with SQL Server, template engine, and notification engine.
System architecture

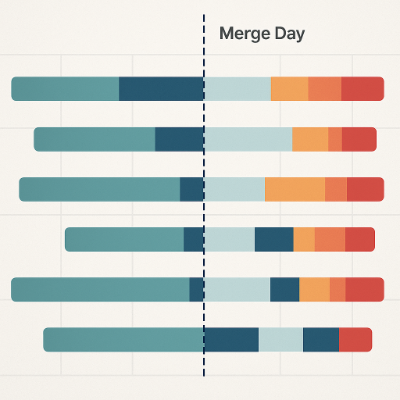

Stacked Gantt chart illustrating multiple projects aligned to a shared pivot date labeled Merge Day.
